By Githaiga Ndiritu|Architecture | Engineering | Construction
Design & Architecture

By Githaiga Ndiritu|Architecture | Engineering | Construction
Most construction losses in Kenya are not caused by bad luck. They are caused by decisions made before the first stone is laid, usually about who was and was not part of the project team. Half-built houses and stalled apartment blocks are rarely the result of one dramatic failure. They are usually the compounding effect of a missing role: no one costing the project properly at the outset, no one checking the structural drawings, no one verifying the contractor's registration.
Kenyan architects and quantity surveyors who work on residential and commercial projects report a consistent pattern: clients who try to save the six to ten percent that architectural and quantity surveying fees would have cost often lose twenty to fifty percent of the project value instead, through overruns, rework, disputes, and a lower resale value on the finished building. The saving at the start becomes a much larger cost at the end.
This is not an argument for hiring more people than a project needs. A small renovation does not require the same team as a five-storey mixed-use development. It is an argument for understanding, before the budget is committed, exactly which professionals a project of your size and complexity actually requires, and at what point each of them needs to be in the room.

A construction project in Kenya is delivered by a small number of distinct professional roles, each with a specific, legally defined scope. Clients frequently conflate them, which is itself a source of disputes later, since work that falls between two roles is work that no one is formally responsible for. The sections below set out what each person is actually accountable for, and to whom.
The architect is the lead designer and, on most projects, the head of the consulting team. Their scope covers interpreting the client's brief, producing drawings for approval and construction, coordinating the input of the other consultants, administering the contract once construction begins and issuing instructions and certifying completion. In Kenya, architects are registered and regulated under the Board of Registration of Architects and Quantity Surveyors (BORAQS).
The structural engineer is responsible for the stability, durability, and safety of the building. These include the foundations, columns, beams, slabs, and roof structure that carry load. They are registered with the Engineers Board of Kenya (EBK). A significant share of structural failures in Kenya trace back to drawings that were never formally approved, or to changes made on site (an added floor, thinner reinforcement, e.t.c) without engineering review.
The quantity surveyor manages the financial side of the project: cost planning from the earliest concept stage, preparing the bill of quantities, evaluating tenders, certifying payments, and pricing variations as they arise. The QS is most useful when engaged from inception, feeding real cost information into the design as it develops, not brought in afterward to price a design that has already been finalised and may no longer be affordable.
Mechanical, electrical, and plumbing (MEP) design is its own discipline, distinct from structural engineering. On anything beyond a simple single residence, the mechanical and electrical layouts need to be designed alongside the structural drawings, not fitted in afterward. One of the most common and expensive design errors is a clash between MEP routing and structural elements (ducting or plumbing) that was never coordinated with the beams and slabs it now has to pass through, discovered only once installation is underway.
The project manager coordinates the workflow between client, consultants, and contractor, and manages the communication that keeps a project moving. On a design-and-build project, this coordinating function is often held by the practice managing the full delivery, rather than a separate appointment.
The contractor executes the construction according to the consultants' drawings and specifications. Contractors in Kenya are classified by the National Construction Authority into tiers (NCA1 down to NCA8) based on technical capacity, financial strength, and project value limits. Engaging a contractor whose registered tier does not match the scale of the project is a common and avoidable risk.
On larger projects, a clerk of works is appointed as a full-time, on-site representative of the client's interests, monitoring day-to-day quality and progress and reconciling what is being built against the drawings. This is distinct from the contractor's own site supervisor, whose job is to run the workforce, not to provide independent oversight of it.
The order in which professionals join a project matters as much as who they are. Bringing someone in too late is functionally similar to not having them at all, because by the time they arrive, decisions have already been made without their input.
A land or site survey comes first, establishing the boundaries, topography, and ground conditions the design will have to respond to. The architect follows, translating the client's brief into a concept and then a scheme design (the small-scale layout submitted for local authority approval). This is also the point at which the quantity surveyor should join, not after the design is finished. A cost plan developed alongside the concept design allows the design to be adjusted while adjustment is still cheap, rather than after it has been drawn, approved, and priced.
Once the scheme design is approved, the structural and MEP engineers develop working drawings in parallel with the architect's detailed design (structural layouts, reinforcement schedules, and mechanical and electrical routing). The quantity surveyor uses these completed drawings to prepare the detailed bill of quantities, which becomes the basis for contractor tenders.
Only once drawings are complete, approved, and priced should a contractor be engaged. Construction then proceeds under the supervision of the consulting team - the architect and engineers providing periodic technical inspection, a clerk of works providing daily oversight where appointed, and the quantity surveyor measuring completed work for payment. The architect certifies practical completion, and a defects liability period follows before retention funds are finally released.

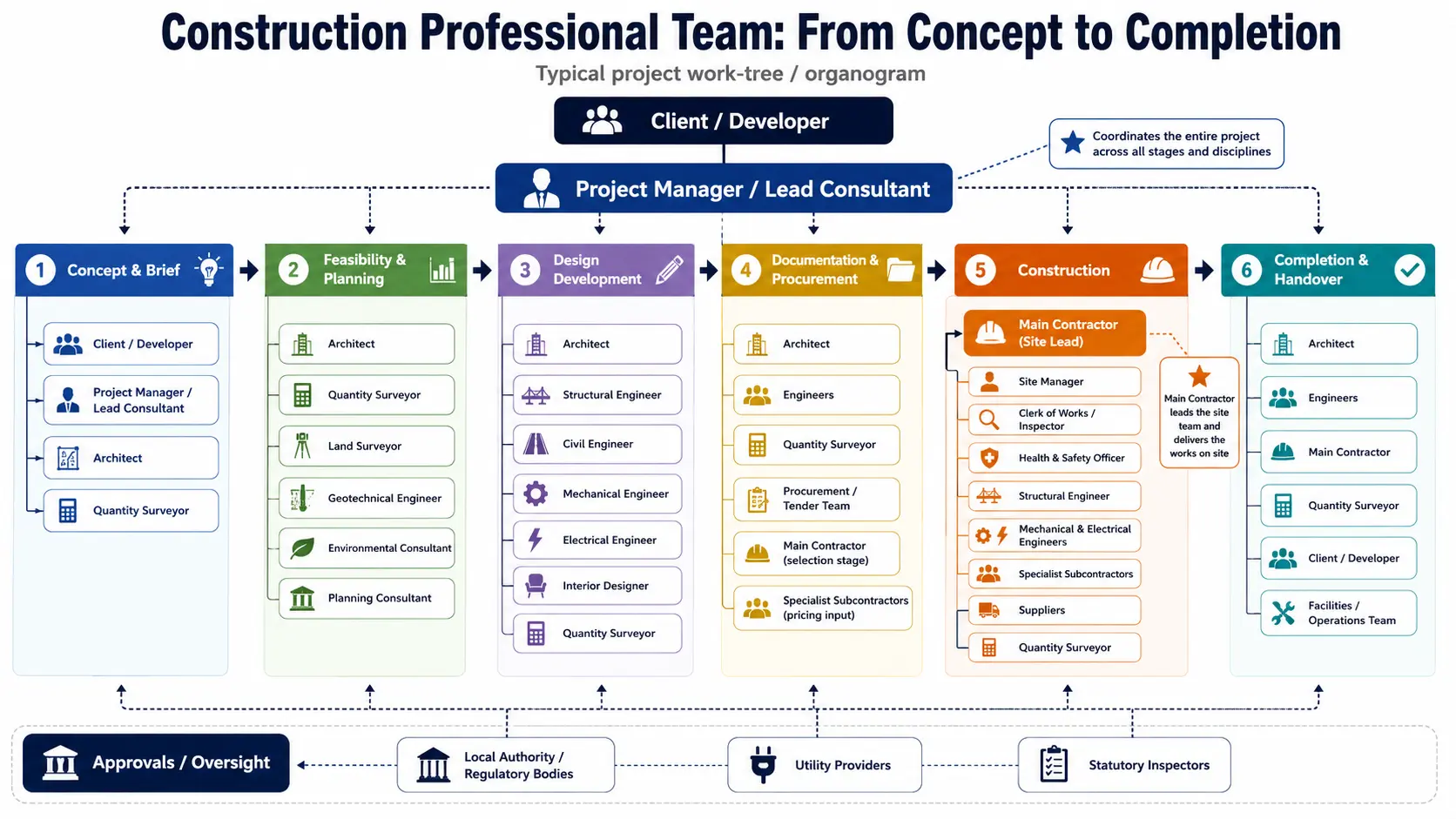

Mapped end to end, the sequence looks less like a flat list of job titles and more like a tree: one root (the client's brief) branching into design, then structure and services, then procurement, then site delivery, with each branch reconnecting at key approval and payment milestones.
Every core member of a Kenyan construction team sits under a regulator, and checking registration before appointment is one of the simplest, most effective safeguards available to a client.
Architects and quantity surveyors are registered with the Board of Registration of Architects and Quantity Surveyors (BORAQS). Structural, civil, mechanical, and electrical engineers are registered with the Engineers Board of Kenya (EBK). Both bodies issue annual practising licences, separate from the underlying registration, which also need to be current.
Contractors are registered with the National Construction Authority under the National Construction Authority Act, and it is unlawful to carry on business as a contractor in Kenya without valid NCA registration and a current practising licence. The NCA groups contractors into eight tiers, NCA1 through NCA8, across three categories (general building, specialist works, and roads and civil works), each with its own project value ceiling. An NCA8 contractor, for example, is typically limited to projects of around KSh 10 million or less in the building category; an NCA1 contractor has no upper limit but is held to a correspondingly higher standard of technical staff and financial capacity. Higher tiers require the firm to employ its own registered engineers, quantity surveyors, and project managers, which is one reason upgrading tiers is difficult for firms that are strong on turnover but thin on qualified senior staff.
For county project registration, this credential-checking is not optional paperwork, it is a formal requirement. Kenyan counties generally require proof that the project's engineer, architect, and quantity surveyor are registered with EBK or and hold valid practising licences, together with other statutory approvals, before construction is permitted to proceed. A client who verifies this independently, rather than relying on the professional's own assurance, closes off one of the more common routes to a stalled or non-compliant project.
The professional team described above is not bureaucracy for its own sake. Almost every expensive mistake on a Kenyan construction site can be traced to one of a small number of recurring gaps in that team.
The quantity surveyor engaged after the design is finished, rather than alongside it, is one of the most common. By the time costs are calculated, the client has already emotionally and financially committed to a design that may be well beyond budget, and value-engineering it after the fact usually means cutting into quality rather than into the design's ambition.
A design coordination gap between structural and MEP elements is another. Ducting, plumbing, and electrical routing that were never checked against the structural drawings tend to surface as a clash only once installation begins on site, at which point the fix is rework, not redesign, and rework is always more expensive than the coordination meeting that would have prevented it.
Structural changes made without engineering review are a third, and among the most dangerous. An additional floor added mid-build, or reinforcement quietly reduced to save on steel, are decisions that belong to a structural engineer, not to a contractor working from memory of what "usually works."
A fourth is engaging a contractor without verifying their NCA registration and tier, sometimes on the strength of a low quote or a personal recommendation alone. Unusually low quotes and a reluctance to provide a written contract are two of the clearer early warning signs that a contractor may cut corners later.
And a fifth is the absence of independent site supervision altogether, assuming that the contractor's own presence on site is equivalent to professional oversight of what is being built against what was designed. The two roles are not interchangeable, and conflating them is one of the more persistent misunderstandings among Kenyan clients.
A well-structured professional team still needs a contract structure that makes accountability explicit, rather than assumed.
Contract administration on a Kenyan building project is typically shared between the architect, who issues instructions and certifies practical completion, and the quantity surveyor, who values completed work and agrees variations. Knowing which of the two to approach for which issue avoids the confusion that lets genuine problems sit unresolved between two consultants who each assume the other is handling it.
The type of contract chosen also determines a client's exposure. A lump-sum contract fixes the total cost against an agreed scope. An item-rate contract pays per measured unit of work completed. A design-and-build contract places design and construction responsibility with a single party. None of these is inherently safer than the others, but each carries different risks, and the choice should be made deliberately, in writing, with clear clauses on timelines, retention, warranties, and how disputes will be handled, not settled by verbal agreement once work is already underway.
Retention (typically five to ten percent of payments due, held back until defects identified at handover have been corrected) exists specifically to protect the client after the contractor has already been paid the bulk of the contract sum. It should never be waived to speed up final payment.
Variation orders deserve particular caution. Any change to scope, specification, or cost after the contract is signed should be captured in writing, priced, and formally approved before the associated work begins - not agreed verbally on site and reconciled later, by which point the client has limited leverage to dispute either the change or its cost.
Every gap described so far is harder to catch from outside Kenya, which is why diaspora clients carry a disproportionate share of this risk. Distance removes the option of dropping by the site unannounced, which is often the only thing that catches a problem before it becomes expensive.
The practical answer is not to try to replicate physical presence remotely. It is to insist on the structures that make physical presence unnecessary: a single point of contact who is accountable for coordinating the full team, rather than five separate professionals each reporting selectively; a documented cost plan and programme agreed before construction starts, so that any deviation is visible against a baseline rather than judged against memory; and a regular, dated reporting rhythm (photographs, progress notes, and payment certificates) that a client can review from anywhere without having to ask for it.
Independent site supervision matters more, not less, for a remote client, because it is the only check on the contractor's own account of progress. A diaspora client who relies solely on the contractor's word for what has been completed and what it cost has, in practice, removed the entire professional team's oversight function from the project.
Everything described in this article (the sequencing, the coordination between structural and MEP design, the shared contract administration between architect and quantity surveyor) depends on the team functioning as one coordinated unit rather than a set of separately hired consultants who meet for the first time on site.
Where design and construction sit under a single, accountable practice, the handoffs that most often produce mistakes (a designer who never has to answer for buildability, a contractor who never had input into the drawings) are reduced by design rather than managed after the fact. This is not the only way to structure a build. Many well-run projects are delivered through separately appointed consultants and contractors, coordinated carefully by the client or a project manager. But it does mean that whichever route you choose, the coordination itself has to be someone's explicit job, not an assumption.
Lesel Buildworks operates as an integrated design-and-build practice for exactly this reason - architecture, engineering, and construction under one team and one line of accountability. If you are weighing up how to structure the professional team for your own project, we are glad to talk it through.
In most cases, yes. A structural engineer confirms the foundation design suits your soil conditions and that the structure safely carries its loads, including any future addition of a second floor. Skipping this step is one of the most common causes of structural failure identified in Kenyan homes, even single-storey ones.
An architect administering the contract is exercising a defined part of their professional scope - issuing instructions and certifying completion under the building contract. A project manager's role is broader day-to-day coordination between client, consultants, and contractor. On many projects, particularly design-and-build ones, a single practice fulfils both functions.
Ask for their NCA registration number and category, and verify it directly against the National Construction Authority's own records rather than relying on a certificate shown to you on site. Confirm the category matches your project's value - a contractor registered for smaller works taking on a project beyond their tier is a genuine risk, not a technicality.
As early as possible, ideally alongside the architect from concept design, not after the drawings are finished. A cost plan developed alongside the design lets you adjust the design while it is still inexpensive to do so, rather than discovering the budget gap once the drawings are complete.
Yes, and many owners do, particularly on smaller projects. It requires you, or a project manager you appoint, to take on the coordination that an integrated practice would otherwise handle i.e.: chasing drawings between consultants, checking for clashes, and holding the contractor to the approved design. It is a workable approach if you have the time and access to do it properly.
Insist on a single accountable point of contact, a documented cost plan and programme agreed before construction starts, and independent site supervision separate from the contractor's own team. Regular dated photographs and progress reports are useful, but they are not a substitute for someone on your side checking the work against the drawings.
It should be treated as a serious issue, not a minor site adjustment. Unapproved changes (an added floor, altered reinforcement) are a leading cause of structural failure in Kenya. Any such change should be reviewed and formally approved by the structural engineer before work continues, and in some cases the affected work may need to be opened up and corrected.
